P.O Box 863, Lafayette, CO 80026
Regulatory ReportingColoradoColorado Form 6 Well Abandonment: What Makes a P&A Filing Stand Up to ECMC Review.

Colorado Form 6 Well Abandonment: What Makes a P&A Filing Stand Up to ECMC Review.

The cheapest Form 6 to prepare is rarely the one that receives the least attention — a weak filing costs far more after submittal than it saved before it.

ECMC Form 6 is the well abandonment report required by the Colorado Energy & Carbon Management Commission (ECMC) for plugging and abandoning oil and gas wells in Colorado. It has two parts: the Form 6 – Notice of Intent to Abandon (NOI), which must be submitted and approved by the Director before plugging work begins, and the Form 6 – Subsequent Report of Abandonment (SRA), which must be filed within 30 days after abandonment operations are complete. Under ECMC Rule 435.a, the NOI and its attachments must fully and consistently describe the proposed depths, sizes, volumes, and materials for the abandonment; under Rule 435.b, the SRA must document and verify the work actually performed.

A strong Form 6 package is complete, internally consistent, and technically defensible. A weak package leaves the ECMC reviewer reconciling missing information, conflicting well data, or an abandonment plan that doesn't clearly demonstrate compliance with Colorado's plugging and abandonment requirements.

Why does a weak Form 6 filing cost more than the correction itself?

A returned or revised Form 6 package can delay a planned P&A operation, disrupt rig and contractor scheduling, and require additional engineering or regulatory review. A filing that results in noncompliance creates more serious exposure: ECMC has authority to investigate alleged violations, impose penalties, issue orders, and require corrective action. If deficiencies are not corrected, the Director may issue a corrective action under ECMC Rule 210.

There is also an operational and credibility cost. Repeatedly submitting Form 6 packages that require substantial correction means more staff time, more back-and-forth with the agency, and greater scrutiny of subsequent filings. A well-prepared package reduces uncertainty before the rig arrives and protects the operator's ability to execute its P&A program on schedule.

Why do Colorado P&A filings face more scrutiny than they used to?

Colorado's regulatory framework for plugging and abandonment has evolved significantly. ECMC's recent regulatory changes place greater emphasis on wellbore integrity and groundwater protection. ECMC Rule 434.a requires operators to plug wells in a manner that isolates specific zones, and ECMC reviewers are looking for a package that demonstrates, on its face, that the proposed plugging program achieves that isolation.

What does a strong Form 6 submittal package look like?

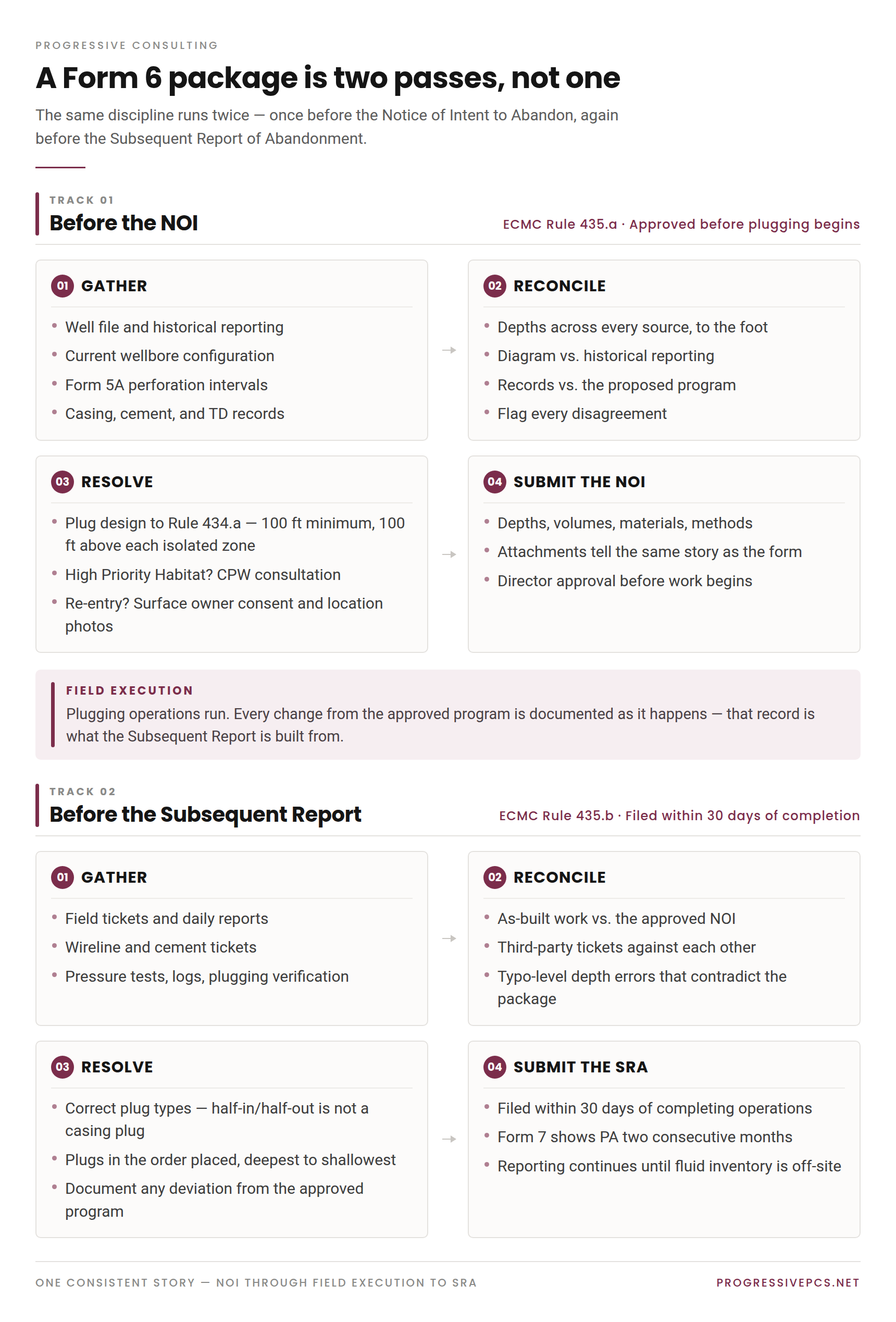

A strong Form 6 submittal demonstrates three qualities: consistency, completeness, and technical defensibility.

The proposed plugging procedure in the Form 6 NOI should be consistent with the well's historical records and current wellbore configuration. The Form 6 SRA should then document the work actually performed — including required pressure test results, logs, and plugging verification reports — and demonstrate that the completed work matches the approved plugging procedure. A strong abandonment package maintains this consistency from the NOI through field execution to the final SRA.

Form 6 – NOI

When it's filed

Before plugging begins

What it must show

Full proposed program — depths, volumes, materials

Governing rule

ECMC Rule 435.a

Form 6 – SRA

When it's filed

Within 30 days of completion

What it must show

Work performed vs. approved NOI

Governing rule

ECMC Rule 435.b

Cement plugs

Minimum length

100 feet

Zone coverage

Extends 100 ft above each isolated zone

Governing rule

ECMC Rule 434.a

What are the most common ECMC Form 6 filing errors?

In Progressive's experience preparing and revising Form 6 packages for Colorado operators, the problems that create the most friction with ECMC review are often straightforward:

Internal inconsistencies

Inconsistencies between the Form 6, wellbore diagrams, historical well information (Form 5 and Form 5A), and the proposed plugging program. Two common examples: depths on the wellbore diagram that differ from historical reporting by a few feet, and depths on wireline and cement tickets that don't agree with each other. Either forces the reviewer to stop and reconcile the record.

Insufficient technical detail

Not enough detail to clearly establish the proposed plugging method — for example, a missing plug or a plug that fails to meet ECMC Rule 434.a, which requires any cement plug to be a minimum of 100 feet in length and extend a minimum of 100 feet above each zone being isolated.

Missing or incomplete attachments

Including third-party tickets with typo-level depth errors that contradict the rest of the package.

Disconnects between the approved NOI and field execution

These become particularly important when preparing the SRA.

Unaccounted site-specific or well-specific conditions

Including locations that fall within a wildlife habitat High Priority Habitat (HPH) requiring consultation or specific BMPs for sensitive areas.

Form 7 reporting that isn't up to date with the proper well status

Form 7, the Monthly Report of Operations, the Monthly Report of Operations, is due 45 days from the last day of the month the well was plugged. From the month the well was plugged, the status should be reported as PA (plugged and abandoned), and the following month must also be reported as PA. Two examples of how this goes wrong:

  • A well is plugged and abandoned in April; April's Form 7 shows PA, but May's shows TA. May needs to reflect PA.
  • Only one month of production reporting shows PA when two consecutive months are required.

If the well produced or injected during the month it was plugged, the Form 7 should report PR or IJ volumes for the number of days the well was active, with the following month reported as PA. Form 7 reporting is also required to continue (as PA) until all fluid inventory is moved off-site.

Reporting incorrect plug types

A common example is a half-in/half-out plug recorded as a casing plug. When casing is cut and a plug sits partially in open hole and partially inside surface casing, it should be recorded on the form as a half-in/half-out plug.

ECMC Form 6 plug entry showing a half-in half-out plug incorrectly recorded as a casing plug, with the corrected entry below

Reporting plugs out of sequence

Plugs should be reported on the form in the order they are placed — deepest to shallowest. This applies to CIBPs, cement plugs, and perforate-and-squeeze entries alike, and to the depth intervals within each entry, which are written deeper depth first.

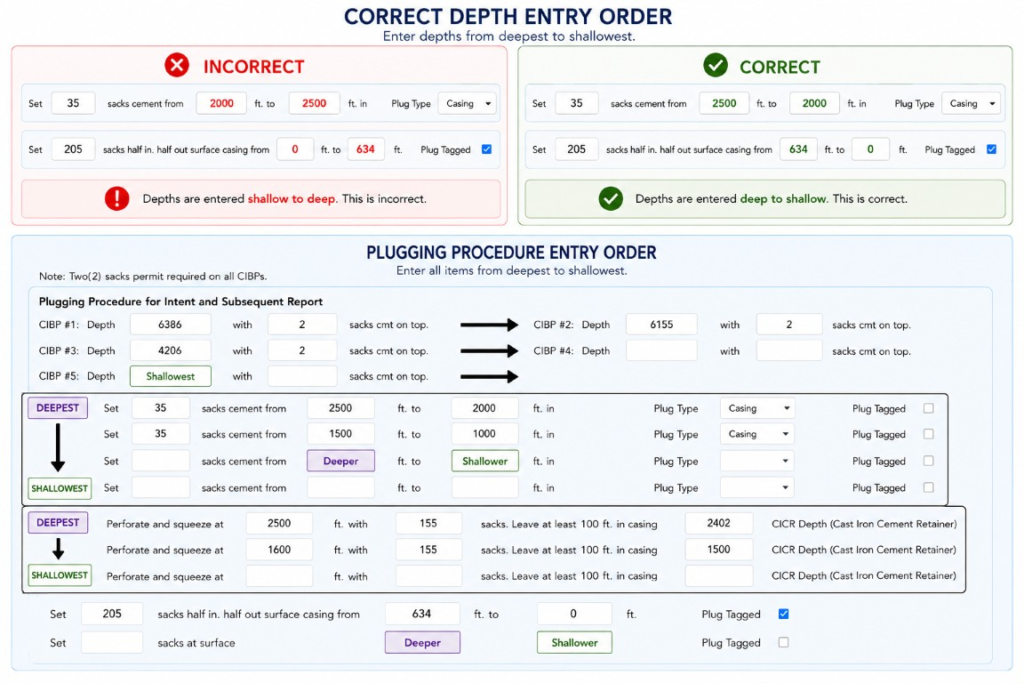

ECMC Form 6 depth entry order: incorrect entry showing depths shallow to deep beside the corrected deep-to-shallow entry, with the full plugging procedure ordered deepest to shallowest

Choosing the incorrect reason for abandonment

If the well is being plugged for a re-entry, that must be noted on the Form 6. A re-entry P&A also requires location photos and surface owner consent, so those conversations need to start early.

Logs that tell a different story than what was originally reported

Cement depths can be updated to reflect what recent logs show; the historical reporting is then superseded and the wellbore diagram should be updated to current conditions — with the change clearly documented so the Form 6 package still tells one consistent story.

Questions worth answering before ECMC asks them for you

  • Does the proposed plugging procedure tell the same story across every part of the Form 6 package, including attachments?
  • Are the current wellbore configuration and historical records consistent with the proposed abandonment plan?
  • Do the diagrams clearly communicate both the existing well and the proposed plugging configuration?
  • Is the well being plugged for a re-entry? If so, have conversations with the surface owner started, and are location photos in hand?
  • Are the proposed depths, cement volumes, casing information, fluids, and other materials adequately documented?
  • Does the location fall within a High Priority Habitat (HPH) that requires consultation with Colorado Parks and Wildlife (CPW)?
  • Could an ECMC reviewer understand the proposed work without reconstructing the operator's reasoning from multiple sources?
  • If the field work changes, can the operator clearly document how the actual abandonment compares with the approved Form 6 NOI when preparing the SRA?
  • Does the current Form 5A on file show the correct perf intervals, and do those depths match the Form 6 submittal package?

Form 6 filings rarely get attention until one comes back with comments — but they quietly decide whether a P&A program runs on schedule or waits on the rig. The package that answers these questions before submittal is the one that clears review.

How long does an operator have to file the Form 6 SRA after plugging a well?

The Form 6 – Subsequent Report of Abandonment must be filed with the ECMC Director within 30 days of completing abandonment operations, documenting and verifying the work performed against the approved NOI.

When is Form 7 due after a well is plugged, and what status should it show?

Form 7, the Monthly Report of Operations, is due 45 days from the last day of the month the well was plugged. The month the well was plugged should be reported as PA, and the following month must also show PA. Form 7 reporting continues until all fluid inventory is moved off-site.

What is a half-in/half-out plug?

When casing is cut and a plug sits partially in open hole and partially inside surface casing, it is a half-in/half-out plug and should be recorded that way on the Form 6 — not as a casing plug.

What are the ECMC cement plug requirements?

Under ECMC Rule 434.a, any cement plug must be a minimum of 100 feet in length and must extend a minimum of 100 feet above each zone being isolated.

What is required for a re-entry P&A in Colorado?

A well being plugged for later re-entry must identify that reason on the Form 6, and the operator must provide location photos and surface owner consent as part of the package.

What happens if ECMC finds deficiencies in a Form 6 filing?

ECMC may return the package with comments requiring revision. If deficiencies are not corrected, the Director may issue a corrective action under ECMC Rule 210, and ECMC has authority to investigate violations, impose penalties, and issue orders.

How Progressive supports Colorado P&A programs

Progressive has 15+ years of experience supporting oil and gas operators of all sizes with Colorado plugging and abandonment programs. Progressive has prepared and submitted ECMC Form 6 NOI and SRA packages and has extensive experience responding to ECMC comments and navigating revisions. Our team understands ECMC’s regulatory expectations as well as the field and technical requirements that must be reflected in a complete and defensible submittal.

That combination of regulatory knowledge and practical P&A experience allows Progressive to identify potential issues before they become filing delays — and helps operators move projects forward with greater confidence.
